What industrial & oilfield piling actually involves

On an industrial or oilfield site the piling is rarely the hard part. Pump jack bases, equipment and compressor skids, pipe racks and sleepers, wellhead and header supports, metering stands, tank and shelter platforms — the engineering is well trodden and the loads are modest by industrial standards. What decides whether a contractor can do the work is whether they can get onto the lease at all: prequalification status, safety documentation, orientation, competency records and a prime contractor determination, all ahead of the first pile.

Check the gate before the bid, because procurement people are tired of finding out at the audit. If your prequalification needs a current COR number or an active account in a particular portal, ask us about it directly before issuing a bid package.

The rest is logistics rather than compliance. Leases are remote, roads seasonal, ground often soft or reclamation-sensitive, and the access window is frequently the binding constraint. A helical crew is small and self-contained — a carrier, a drive head, an operator and steel — with no concrete truck to route in and nothing to cure.

How the job runs

Almost all of it happens before anyone mobilises. Prime contractor is determined in writing. A site-specific hazard assessment and job safety analyses are written for the actual scope rather than pulled off a shelf. Orientation is completed to the operator's system, whatever it is. Ground disturbance permits, locates including operator-owned lines, crossing agreements and work permits close out before steel arrives. Where a site's classification calls for tickets or monitoring we do not carry, we say so and either arrange it or decline the scope.

On the ground the sequence bends around access rather than weather. Matting is planned for soft ground and for surfaces where rutting is itself the liability, and winter access is often easier than summer because frozen ground carries a machine that muskeg will not. Torque is logged per pile and correlated to capacity, and the record is handed over rather than described. With no cure, a millwright can set the skid behind us the same day, which is why helicals appear on turnaround schedules. At end of life the piles come out and the steel is recoverable.

What decides the spec

Uplift, reversal and lateral demand usually govern rather than dead load. A pump jack applies a cyclic, reversing load through its base. A pipe rack has to be resolved into guide bays and anchor bays, because thermal movement in the line puts longitudinal thrust into particular supports and not others. Wind on a tall, light stand can outweigh everything the structure carries. A rack designed as though every bay were identical is a rack that moves at the anchor.

Corrosion and clearance drive the rest. Where the geotechnical or environmental work reports saline soils, resistivity concerns or produced-water spills, the coating system and a sacrificial wall allowance belong in the specification explicitly, with a design life stated. Spacing is often set by the buried pipe corridor rather than by soil mechanics, since clearance from live piping can rule out the location the drawing wanted.

Areas We Serve for Industrial & Oilfield Piling

We provide industrial & oilfield piling across Calgary and area. Ground conditions and permitting authority differ by community — pick yours for the local detail.

Industrial & Oilfield Piling in practice

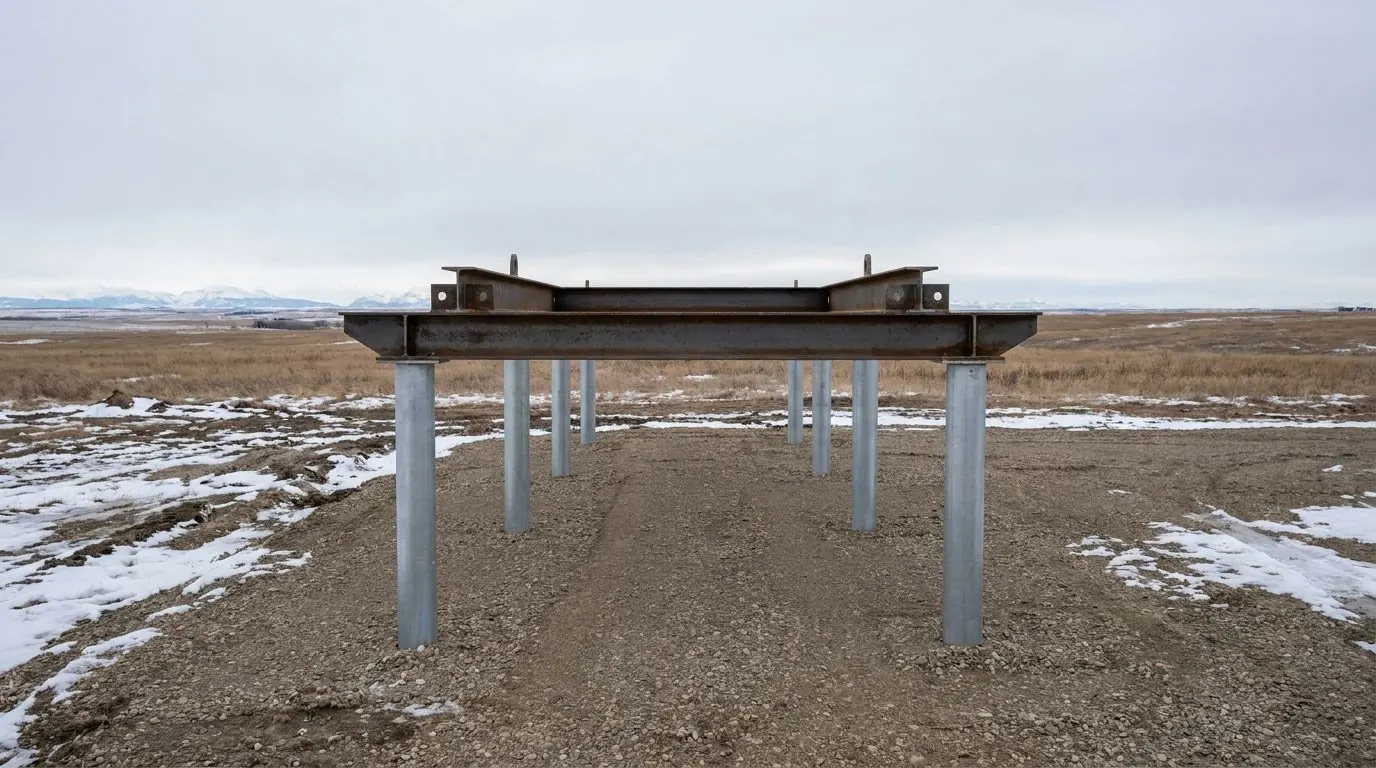

An industrial equipment skid mounted on steel pile supports on a gravel lease pad in Alberta.
Equipment skid on a pile foundation

Frequently Asked Questions about Industrial & Oilfield Piling

How deep do screw piles need to go in Alberta?
Screw piles must extend below the frost line, which runs 1.2 to 1.8 metres deep in the Calgary area. In practice the final depth is governed by installation torque rather than a fixed measurement — the pile is advanced until it reaches the torque that correlates to the engineered capacity required. Two piles on the same site can finish at different depths and both be correct.
Are screw piles cheaper than concrete?
On materials alone, concrete can look cheaper. Once you add excavation, spoil removal, forming, and the days lost to curing, screw piles are usually competitive and often less — and you can build on them the same day they go in. We will give you both numbers honestly rather than steering you.
What are the downsides of screw piles?
They are not right for everything. Very rocky ground or shallow bedrock can stop a pile short of depth, which sometimes calls for a different pile size or a different foundation entirely. They also need proper engineering to be worth anything — an unverified pile with no torque record is just a post in the ground. If piles are the wrong answer for your project, we will say so.
Can screw piles be installed in winter?
Yes. Frozen ground is not a barrier — piles are installed year-round in Calgary, which is one of the main advantages over concrete. Winter is often the easiest time to book us.
